SpotatrainSpotatrain
HS2
Spotatrain contributor

Mega Project

Under Construction

HS2

The London-to-Birmingham high-speed line, reset in May 2026 with a later opening, a higher cost and a lower top speed.

London → Birmingham

Updated

Length

225 km

Max speed

320 km/h

Stations

4

Tunnels

10

Bridges

169

Budget

GBP 102.7B

HS2 is the high-speed railway from London to Birmingham, cut back in 2023 and reset in May 2026: the Department for Transport now gives a cost of £87.7-102.7bn and first services between 2036 and 2039.

About This Project

HS2 is a new high-speed line from London to the West Midlands. HS2 Ltd gives its length as about 140 miles (225 km), measured between London and HS2's connection to the West Coast Main Line, so it includes the Birmingham branch and the link to Handsacre Junction in Staffordshire. There are four stations: London Euston, Old Oak Common in west London, Birmingham Interchange in Solihull and Birmingham Curzon Street. The map on this page shows the line from HS2 Ltd's public route layer, which reflects a 2015 design.

The scheme is far smaller than the Y-shaped network once planned. On 4 October 2023 Prime Minister Rishi Sunak announced that the line would not be built between Birmingham and Manchester, and redirected funding to a £36bn 'Network North' programme. Andy Burnham became Prime Minister on 20 July 2026. On 19 August 2026 he said that 'a new rail line, I think, is needed' to Manchester but that 'it won't be HS2 as was'; its form is still to be agreed. On 14 September 2026 the Department for Transport (DfT) permanent secretary told the Public Accounts Committee (PAC) of the new administration's commitment to build a new line north from Birmingham to Manchester, with no route, date or funding published. In May 2026 DfT had said safeguarding was lifted between the West Midlands and Leeds, that compulsory purchase powers on the former Phase 2a route expired on 11 February 2026, and that land between the West Midlands and Crewe would be retained.

On 19 May 2026 Transport Secretary Heidi Alexander set out the result of the reset led by HS2 Ltd chief executive Mark Wild. DfT now expects HS2 to cost £87.7-102.7bn on a mixed price base (actual spending to date plus future work at current prices), about US$118-139bn, or £70.9-82.2bn in 2019 prices against a previous range of £35-45bn. First services between Old Oak Common and Birmingham Curzon Street are expected between May 2036 and October 2039, and the full scheme to Euston and Handsacre between May 2040 and December 2043. Mark Wild's ambition of £93.2bn and an opening in late 2037 sits deliberately in the lower half of those ranges, and the report says HS2 Ltd could report above it; on 4 November 2026 Wild said he aims for 2037 or earlier. HS2 Ltd aims to set a new cost and schedule baseline in spring 2027. By the end of March 2026, £44.2bn had been spent (£46.8bn including the cancelled Phase 2), in nominal prices.

Building continues at scale, though HS2 Ltd said on 3 November 2026 that it must slow or pause some work, including most work between Birmingham and Handsacre. HS2 Ltd says about 30,000 people and more than 3,500 UK businesses work on the railway. The Chiltern Tunnel (about 16 km / 10 miles) was fully bored in March 2024, the Colne Valley Viaduct (3.4 km / 2.1 miles) was announced complete by its builders in September 2025, and all six high-speed platforms at Old Oak Common have been built. On 4 November 2026 HS2 Ltd announced a breakthrough connecting the Old Oak Common station box to the Northolt tunnel.

The trains are to come from a Hitachi-Alstom joint venture, which won a £1.97bn contract in December 2021 for 54 trains, each 200 m (656 ft) long; HS2 Ltd's website now says 52 and no explanation was found. The National Audit Office (NAO) notes that stations north of Birmingham cannot take two coupled units, that a single 200 m unit would carry fewer passengers than today's West Coast Main Line trains, and that DfT intends to decide what trains are needed by 2028.

Video

Why This Project Matters

The case for HS2 has rested on capacity as much as speed. The NAO reports that DfT is examining what trains are needed to address capacity concerns on the West Coast Main Line, and warns that a single 200 m unit north of Birmingham would carry fewer passengers than the trains running there today and could not match their speed on some sections. At the PAC on 14 September 2026 DfT's Dean Creamer said 'that is not where we are planning to end up', with talks under way with the manufacturer. Announcing the reset, the government said peak long-distance fast rail capacity between London and the West Midlands is expected to double and that London-Birmingham journeys will be about 30 minutes faster. HS2 Ltd gives 49 minutes from Euston to Curzon Street at 360 km/h, against 77 minutes for the fastest current train to Birmingham New Street, and DfT says the move to 320 km/h adds about three minutes; these figures do not exactly match the government's 30 minutes.

The wider case, as DfT presents it, is regional growth around the Birmingham stations and the redevelopment of Euston, where the government has named Lendlease as Master Development Partner. The NAO has told DfT to focus on maximising these benefits now that the programme could cost up to £102.7bn.

Technical Details

The civil works of HS2 are built to the original 360 km/h (225 mph) specification, but DfT agreed in May 2026 that trains will run at up to 320 km/h (200 mph). The NAO explains that HS2 Ltd will remove a new train control system and reduce the signalling specification, which cuts testing time and avoids the risk that testing shows 360 km/h is not feasible. HS2 Ltd's initial assessment is that the change could save between £1bn and £2.5bn and may allow opening at least a year earlier, while the NAO adds that slower journeys reduce long-term benefits by about £1.3bn. Automatic train operation is also removed from the opening scope. HS2 Ltd's own website still quotes its 49-minute journey time at 360 km/h.

HS2 Ltd lists five twin-bore tunnels (Euston 7.3 km / 4.5 miles, Northolt 13.6 km / 8.4 miles, Chiltern 16 km / 10 miles, Long Itchington Wood 1.6 km / 1 mile, Bromford 5.8 km / 3.5 miles) and five green tunnels (Copthall, Wendover, Greatworth, Chipping Warden and Burton Green, 0.7-2.7 km each). It counts 681 structures under construction, among them 52 viaducts, 169 bridges, 110 embankments and 71 cuttings.

Birmingham Interchange has two 415 m (1,362 ft) island platforms and, HS2 Ltd says, was the first railway station in the world to receive a BREEAM 'outstanding' rating. An automated people mover on a 2.2 km (1.4 mile) viaduct is planned to link it to the NEC, Birmingham International and the airport. Curzon Street has a 70 m (230 ft) wide arched roof. Old Oak Common will have six HS2 platforms of 450 m (1,476 ft) beside eight conventional platforms. The trains are 200 m (656 ft) long, 8-car units and, per Alstom, will be built at Newton Aycliffe, Derby and Crewe.

Economic Impact

HS2 Ltd says about 30,000 people and more than 3,500 UK businesses are working on the railway and that it has invested £23m in community work along the route. DfT expects the reset to deliver journeys about 30 minutes faster between London and Birmingham and to double peak long-distance fast rail capacity between London and the West Midlands.

The NAO's June 2026 report is more guarded: it notes that slower trains reduce long-term benefits by about £1.3bn and that DfT's benefit-cost ratio for completing the scheme (1.5 to 6.4) excludes sunk costs, includes avoided cancellation costs and, per the NAO's note, excludes the speed reduction. It asks DfT to develop its benefits strategy with local and central government. DfT estimates total public funding for Euston at about £8bn (mixed price base), of which £3.8bn has been spent, and the NAO says the total will rise once private finance for the station is confirmed.

Environmental Impact

HS2 Ltd says it plans to plant seven million trees and shrubs over about 33 sq km (13 sq miles), and describes Curzon Street as 'Net Zero in operation'. These are the project's own claims; no independent verification was found.

The cost is real woodland. HS2 Ltd's November 2024 report states that Phase 1 will affect 25 ancient woodlands, with about 20.6 hectares (51 acres) lost, down from 29 hectares forecast in the Environmental Statement and from 32 woodlands forecast. The Woodland Trust counts 55 ancient woods suffering direct loss or harmful indirect effects, says about 20 hectares have been felled, and says HS2 has not always acted in line with best practice; its harsher criticism of compensation measures concerns the cancelled Phase 2b strategy.

For Bechstein's bats, HS2 Ltd is building a structure of about 1 km (0.6 miles) at Sheephouse Wood in Buckinghamshire, up to 10 m (33 ft) high and four tracks wide, at an estimated £95m in 2019 prices. Five green tunnels (Copthall, Wendover, Greatworth, Chipping Warden, Burton Green) keep the line under the surface in sensitive landscapes.

Challenges & Controversies

The NAO reported on 29 June 2026 that costs have doubled since 2020, measured against the 2020 estimate for Phase 1 alone and excluding inflation, because of cost underestimation, inefficient delivery and scope changes. DfT attributes two-thirds of the increase to missed scope, under-estimation and inefficient delivery, and one-third to inflation. The NAO says the May 2026 estimates have a high level of uncertainty and advises DfT not to put the reset plans into action until it is confident they can be delivered. DfT's re-assessed benefit-cost ratio is 1.5 to 6.4, which includes avoided cancellation costs and excludes sunk costs; the NAO notes the decision to continue rested on advice that the ratio exceeded 1.5 rather than on the full range, and DfT says it would have been 0.3 to 0.4 had today's costs been known in 2020. At the PAC on 14 September 2026 MP Rupert Lowe challenged the cancellation-cost method and asked for independent verification; Mark Wild said he understood the concern about a vested interest, defended the method and called the estimate conservative. Wild also said the ends of the cost range include no-deal scenarios.

On contracts, HS2 Ltd said in July 2026 that the pre-2020 civil engineering contracts put nearly all risk on taxpayers and that the original £15bn civils budget was spent by 2024 with work far from complete. It renegotiated the EKFB and Align contracts on 31 July 2026; talks with SCS and BBV continue, and Wild told the PAC he hoped to conclude them before Christmas. Three further contracts (the two stations and the trains) are aimed at March 2027. The NAO found that HS2 Ltd's earlier attempts at renegotiation were unsuccessful.

The government's response is that six major construction milestones were met ahead of schedule in the last financial year (2025/26), that about 300 back-office roles have been cut, and that cancelling could cost as much as completing.

On 4 November 2026 a Brent councillor reported serious cracks in homes on Claremont Road near Queen's Park, which residents attribute to tunnelling. HS2 Ltd replied that ground settlement had been small in magnitude and that it would compensate if a material effect were shown. Nothing has been established.

The environment is the other front. HS2 Ltd's November 2024 report says its Phase 1 work will affect 25 ancient woodlands (32 had been forecast), with about 20.6 hectares (51 acres) of ancient woodland lost. The Woodland Trust counts 55 ancient woods on the route suffering direct loss or harmful indirect effects. The bat protection structure beside Sheephouse Wood in Buckinghamshire, about 1 km (0.6 miles) long, is estimated by HS2 Ltd at about £95m in 2019 prices; HS2 says it will let rare Bechstein's bats cross the line without being harmed by trains.

Watch this project live

A railway webcam covers this project — see what is running right now.

  • Camden Junction

    Les trois cameras de Camden Junction sur la West Coast Main Line

    Watch live

Project Timeline

January 14, 2009announcement

HS2 Ltd incorporated

High Speed Two (HS2) Ltd was established as a corporate body on 14 January 2009 to develop the case for a new high-speed railway.

Source
January 10, 2012approval

Government announces HS2 will go ahead

Transport Secretary Justine Greening told Parliament that HS2 would go ahead. She gave £32.7bn at 2011 prices as the capital cost of the full Y network and said London to the West Midlands was expected to open in 2026.

Source
February 23, 2017approval

Royal Assent for the High Speed Rail (London - West Midlands) Act

The Phase 1 hybrid bill received Royal Assent, giving HS2 Ltd the powers to build the line between London and the West Midlands.

Source
April 15, 2020groundbreaking

Notice to Proceed issued for Phase 1 construction

The Department for Transport approved HS2 Ltd issuing Notice to Proceed to the four main works civils contractors, moving the contracts from design to full construction of Phase 1.

Source
December 9, 2021construction

Hitachi-Alstom joint venture wins rolling stock contract

A 50/50 Hitachi-Alstom joint venture won a £1.97bn contract to build 54 trains, each 200 m long, with an initial 12-year maintenance contract.

Source
October 4, 2023cancellation

Phase 2 to Manchester cancelled

Prime Minister Rishi Sunak announced that the HS2 line between Birmingham and Manchester would not be built, and set out a £36bn Network North programme instead.

Source
March 20, 2024construction

Chiltern Tunnel second bore completed

The machine Cecilia broke through at the northern portal near Wendover, about three weeks after her sister machine Florence (27 February 2024), completing the 10-mile twin-bore Chiltern Tunnel.

Source
July 17, 2024cancellation

New government will not revive the northern leg

In the King's Speech the Labour government confirmed it would not reverse the 2023 cancellation, repurposing the High Speed Rail Bill for east-west links in the north of England.

Source
September 5, 2024construction

Last deck segment of the Colne Valley Viaduct installed

Structural work on the 3.4 km viaduct finished one month ahead of plan. Align JV announced the viaduct fully complete in September 2025, after parapets, noise barriers and drainage were finished.

Source
May 19, 2026setback

Reset announced: £87.7-102.7bn, first trains 2036-2039, 320 km/h

Transport Secretary Heidi Alexander told Parliament that HS2 would cost £87.7-102.7bn (mixed price base), open Old Oak Common to Curzon Street between May 2036 and October 2039 and the full scheme between May 2040 and December 2043, with trains at up to 320 km/h.

Source
July 31, 2026construction

New contracts signed with EKFB and Align

HS2 Ltd replaced the pre-2020 civil engineering contracts for more than 100 km of the route with new terms rewarding efficient delivery. Talks with SCS and BBV continued.

Source
August 19, 2026announcement

Prime Minister Burnham: a new line to Manchester is needed, but not 'HS2 as was'

Andy Burnham, Prime Minister since 20 July 2026, said a new rail line to Manchester is needed and that it will not be HS2 as was; its form is still to be discussed and agreed. No route, date or funding has been published.

Source

Videos

HS2 Project Update, October 2026

Photos

Birmingham Proof House junction and Curzon Street station with HS2 approach viaducts

Photo: kitmasterbloke

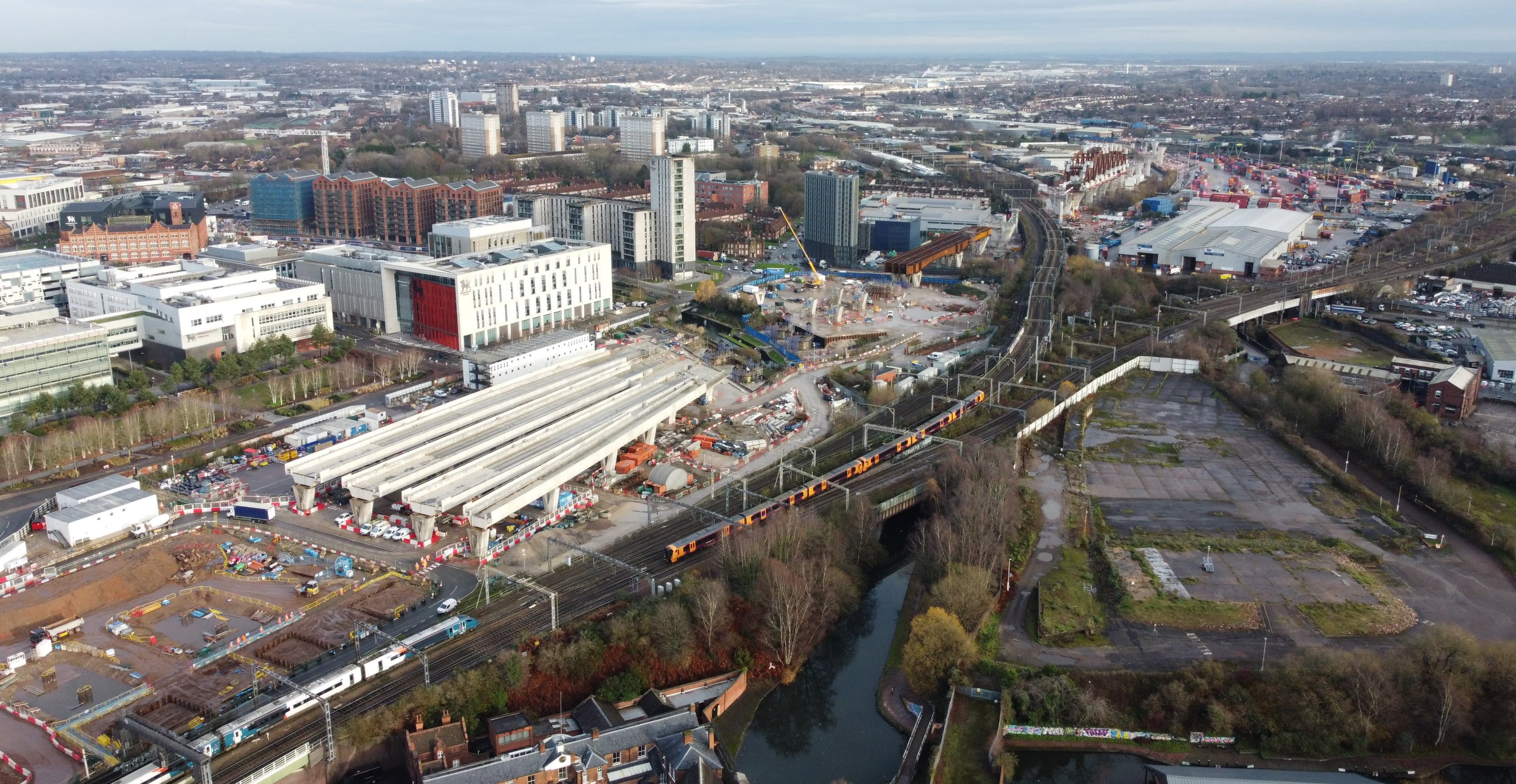

HS2 approach into the city at Duddeston

Photo: kitmasterbloke

Looking towards HS2 - geograph.org.uk - 6955573

Photo: Christine Matthews

Frequently Asked Questions

When will HS2 open?▾
The Department for Transport (DfT) said on 19 May 2026 that services between Old Oak Common and Birmingham Curzon Street would start between May 2036 and October 2039, and the full railway to Euston and Handsacre Junction between May 2040 and December 2043. HS2 Ltd chief executive Mark Wild's ambition, set deliberately in the lower half of those ranges, is late 2037; on 4 November 2026 he said 2037 or earlier. The National Audit Office (NAO) says the estimates carry a high level of uncertainty. A firmer baseline is due in spring 2027: Wild aims for one by Christmas and confidence by April, without guaranteeing it. HS2 Ltd said on 3 November 2026 that it must slow or pause some work, including most work between Birmingham and Handsacre.
Will HS2 still go to Manchester or Leeds?▾
Not as originally planned. Prime Minister Rishi Sunak cancelled the Birmingham-Manchester section on 4 October 2023, and the Labour government said in July 2024 it would not revive it. Andy Burnham, Prime Minister since 20 July 2026, said on 19 August 2026 that a new line to Manchester is needed but 'won't be HS2 as was', and its form is still to be agreed; DfT's permanent secretary told the Public Accounts Committee on 14 September 2026 of a commitment to build a new line north from Birmingham to Manchester. No route, date or funding is published. For Leeds, safeguarding of the land has been lifted and DfT is selling surplus properties (DfT, May 2026). HS2 trains are to continue beyond Birmingham on the existing West Coast Main Line via Handsacre Junction.
How much will HS2 cost?▾
DfT's May 2026 range is £87.7-102.7bn on a mixed price base, or £70.9-82.2bn in 2019 prices, against a previous £35-45bn in 2019 prices. An indicative estimate including projected inflation is £94.3-112.4bn. To the end of March 2026, £44.2bn had been spent (£46.8bn counting the cancelled Phase 2), in nominal prices. HS2 Ltd is to set a new baseline in spring 2027. Mark Wild told the Public Accounts Committee that the ends of the range include no-deal scenarios.
Why has HS2 gone so far over budget?▾
DfT attributes two-thirds of the increase to missed scope, under-estimation and inefficient delivery, and one-third to inflation. The NAO describes the causes as cost underestimation, inefficient delivery and scope changes, and says costs have doubled since 2020. HS2 Ltd says the old civil engineering contracts put nearly all risk on taxpayers; it has renegotiated two and is still negotiating two others.
How fast will HS2 trains go?▾
Up to 320 km/h (200 mph), not the 360 km/h (225 mph) first planned. DfT agreed the change in May 2026; HS2 Ltd's initial assessment is that it could save between £1bn and £2.5bn and may allow opening at least a year earlier, and DfT says it adds about three minutes to the journey. The NAO adds that slower trains reduce long-term benefits by about £1.3bn. The civil works are still built to the original specification, and automatic train operation is removed from the opening scope.
Will HS2 trains run into London Euston?▾
Eventually, but not at first. Services start at Old Oak Common. The HS2 station at Euston is to have 6 platforms. DfT is exploring a public-private partnership and other finance such as tax increment financing; the NAO reports detailed design by the end of 2031 and private finance in the early 2030s, and DfT's permanent secretary told the Public Accounts Committee a financing plan might come with a spending review in the next year. DfT estimates public funding for Euston at about £8bn (mixed price base) with costs still at an early stage. HS2 Ltd expects the tunnel from Old Oak Common to Euston to be finished in mid-2027.
What is the longest tunnel on the route?▾
The Chiltern Tunnel, about 16 km (10 miles) of twin bore under the Chiltern Hills, which HS2 Ltd calls its longest tunnel. Two machines, Florence and Cecilia, bored it, finishing in February and March 2024 at an average of 16 m a day and at depths of up to 80 m (260 ft).
Would cancelling HS2 now save money?▾
The government's assessment in May 2026 was that cancelling could cost as much as completing the railway while delivering none of its benefits. The NAO notes that DfT's benefit-cost ratio for completing, 1.5 to 6.4, excludes money already spent and includes avoided cancellation costs, and that the decision to continue rested on advice that the ratio exceeded 1.5. At the Public Accounts Committee on 14 September 2026 MP Rupert Lowe asked for independent verification of the method; Mark Wild defended it and called the estimate conservative.
